Map extract showing rural electrification areas in County Kerry, including Sneem, Templenoe and Kenmare.Area: Templenoe
Started: October 1958
Finished: April 1959
Poles used: 737
Line used (km): 59
Premises connected: 87

The figures above were sourced from our REO News magazine. Click interactive map to find out more on what the figures mean. The map above shows the area boundary and is from a digitised version of the original map  used during the scheme.

Black Valley was connected under this area in 1977:

Under the second stage of the Electricity Supply (Amendment) bill, the Black Valley area was connected in December 1977. Before connection many people in the area used small generators or batteries to power lights, appliances and machinery. Black Valley was one of the last mainland communities to be connected to the grid and received a lot of attention with the national press.

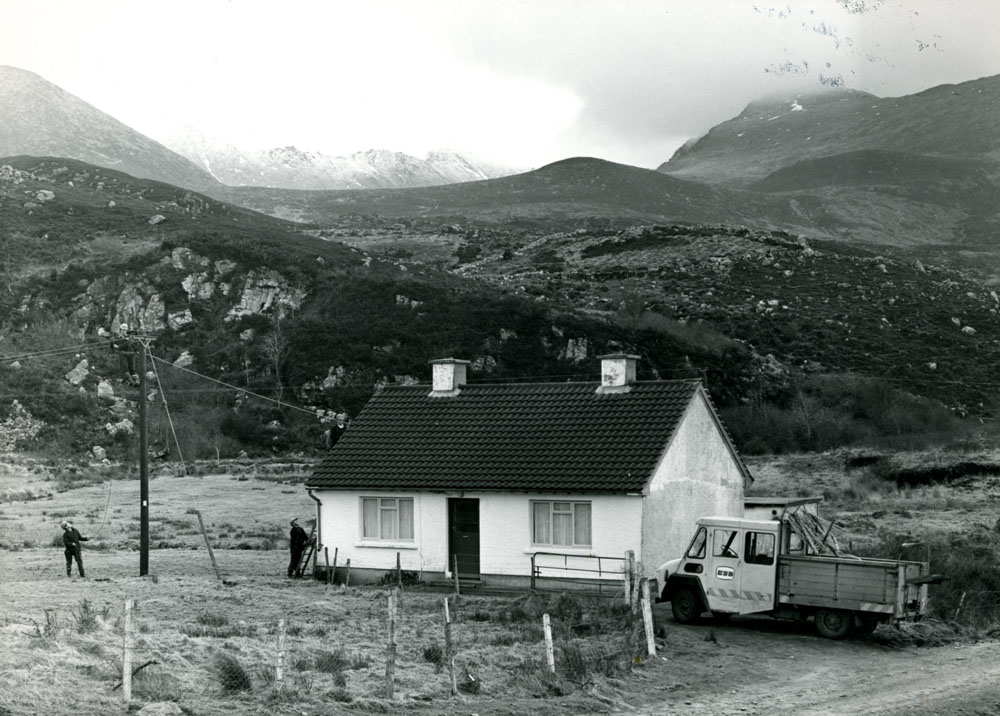

Black-and-white photograph showing an ESB crew working on an electricity service connection beside a rural house, with a utility vehicle parked nearby and mountains in the background.Post development work, Black Valley, 1977.
